Sourcing SMT Equipment from China: A Risk-Managed Procurement Guide

Risk-managed procurement of SMT equipment in China: supplier verification on a live RFQ, payment and contract terms, and how to keep the warranty enforceable after delivery.

Buying Guide

Sourcing SMT Equipment from China: A Risk-Managed Procurement Guide

A risk-managed route to buying SMT equipment in China — verify on a live RFQ, fix payment terms, keep the warranty enforceable after delivery.

Direct answer: Sourcing SMT equipment from China can cut capital costs by 40–60% compared with Japanese or European equivalents — but roughly 60–70% of suppliers that present themselves as factories are actually trading companies. The risk is manageable: verify registration, factory substance, certification, references and patents, score every shortlisted supplier, protect payment (never 100% upfront), and lock performance guarantees into the contract. This guide walks you through that process step by step.

Key Takeaways

Cost Savings40–60% vs. Japanese or European equivalents
Supplier Reality60–70% of “factory” claims are trading companies
Verification5 checks: registration, factory, ISO, references, patents
Payment SafetyNever 100% upfront — 70/30 T/T or L/C at sight
Contract CorePerformance guarantees + 30-day acceptance + neutral arbitration

Who This Guide Is For

For first-time SMT equipment buyers in China — and for anyone burned by a supplier that was only a middleman.

  • First-time importers sourcing printers, mounters, reflow ovens or inspection machines from China
  • Production managers adding capacity or replacing aging lines
  • Purchasing teams evaluating Chinese suppliers on B2B platforms
  • Factory owners building or expanding SMT lines on a budget
  • Anyone who suspects their current supplier is a trading company rather than a manufacturer

Run it on a real purchase: the checks cost a few hours and go to 3–5 candidates in parallel, so all answer the same questions.

  • Registration scope from the registry
  • Tour date and what was visible
  • Certificate number, checked on the registry
  • Reference customers in your industry
  • Patent numbers behind claimed technology

A supplier who answers all five in a working day makes the shortlist; one who defers the fifth shows how a warranty claim will be handled.

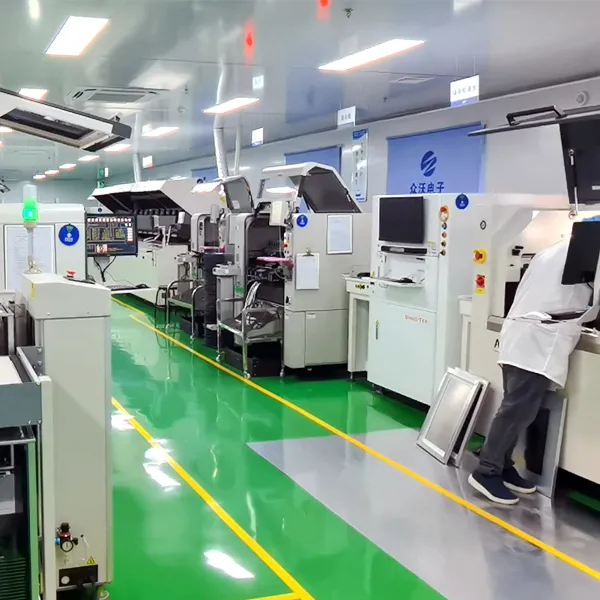

Machines in assembly and test positions along a clean factory hall with yellow floor markings
The first question in sourcing is not price: it is whether there is a factory floor to look at, and what is actually standing on it.

The Sourcing Roadmap: From RFQ to Factory Acceptance

SMT equipment is a capital decision, not a commodity order. Follow these eight steps in order — each removes a risk.

  1. Step 1: Define Your Requirements

    Document line configuration, machine types, throughput target, PCB and component portfolio, budget and timeline first.

  2. Step 2: Build a Shortlist

    Identify 3–5 candidates from B2B platforms, referrals and trade shows. Leverage comes from a shortlist.

  3. Step 3: Run the 5-Step Verification

    Check registration, factory substance, ISO certification, references and patents for every candidate.

  4. Step 4: Score and Shortlist

    Score each supplier against the scorecard. Drop any that fails on verification, payment terms or sample testing.

  5. Step 5: Protect Payment

    Never pay 100% upfront: use 70% T/T deposit + 30% before shipment, or L/C at sight for large orders and new suppliers.

  6. Step 6: Lock the Contract

    Put performance guarantees, a 30-day acceptance period, warranty scope, bilingual terms and neutral arbitration in writing.

  7. Step 7: Plan Logistics and Customs

    Confirm Incoterms, HS code, import duties and Form E/F eligibility with your customs broker.

  8. Step 8: Accept and Commission

    Inspect on arrival, test against guaranteed specifications, verify burn-in, then scale with a pilot.

Row of SMT machines in an assembly hall with yellow floor lines and overhead lighting
A roadmap is a sequence of gates: each step removes a class of risk before the next one spends money.

Manufacturers vs. Trading Companies: Know What You Are Buying

Manufacturers design, build and quality-control in their own factory; traders resell from several factories with no control. Platform audits suggest 60–70% of “factory” claims on Chinese B2B platforms are resellers.

Not every trading company is a scam, but you buy through a middleman: no control over quality, no floor to audit, weak warranty enforcement.

Dimension Genuine Manufacturer Trading Company
Production control Own factory; in-house assembly and testing Outsourced; no factory floor to audit
Quality control In-house QC with burn-in / aging tests Relies on its suppliers; inconsistent
After-sales Direct engineering support and stocked spare parts Broker; support depends on the actual factory
Verification Passes live factory tour and registration scope check Often fails registration scope or cannot show a floor
Price Higher than pure traders — reflects real cost Lower sticker price, higher risk and rework cost
Risk profile Manageable with the verification process below Disappearance risk; warranty hard to enforce
SMT printer frames and assemblies being built in a manufacturing workshop
Production control is visible: in-house assembly means the party quoting is the party building, and the party answerable for defects.

The 5-Step Supplier Verification Toolkit

Run all five checks in order on every shortlisted supplier. A real manufacturer passes all five; a trading company fails by step two.

JHIMS solder printer assembly workshopOfficial Registry1. RegistrationSearch the company on gsxt.gov.cn; the business scope must include “manufacturing”.Learn more →SMT production line in a cleanroom factoryVideo Evidence2. Factory TourRequest a real-time video tour: machining, assembly, burn-in testing and headcount.Learn more →JHIMS solder printer demonstration workshopRegistry Check3. CertificationVerify the number on the SGS/TÜV/BSI registry; scope “design and manufacturing”.Learn more →Customer PCB production workshopCustomer Calls4. ReferencesAsk for 2–3 customers in your industry and call them: response time, spare parts, specs.Learn more →JHIMS solder printer aging test workshopPatent Search5. PatentsIf proprietary technology is claimed, check the patent number in the CNIPA database.Learn more →Vertical CNC machining center with enclosure, control panel and tool holders in a machine shopTooling6. Machining CapabilityMost concrete part of a live tour: the machines and parts being cut are there, or not.

Scoring Suppliers: The Weighted Evaluation Scorecard

Score every supplier on the same eight dimensions — a repeatable evaluation. Drop any that fails on sample testing or payment terms, at any price.

Dimension What to Check Pass Standard
Business registration Company registry entry (gsxt.gov.cn) Scope shows “manufacturing”; registered capital consistent with claims
Factory substance Live video tour or on-site visit Machining, assembly, test and aging areas visible
Quality certification ISO 9001 certificate (or applicable standard) Valid and verifiable on the certifying body’s registry; scope = design & manufacturing
Reference customers 2–3 calls in your industry and region Same-industry references willing to speak directly
Patents Patent search on claimed technology Key patents verifiable and held by the supplier
Sample testing Machine demo or sample run on your product Measured specification (rejection rate, UPH) on your product
Payment and contract Proposed payment and guarantee terms No 100% upfront; performance guarantees + acceptance period in writing
After-sales and warranty Response time, spare parts, warranty scope Documented response SLA and spare-parts availability

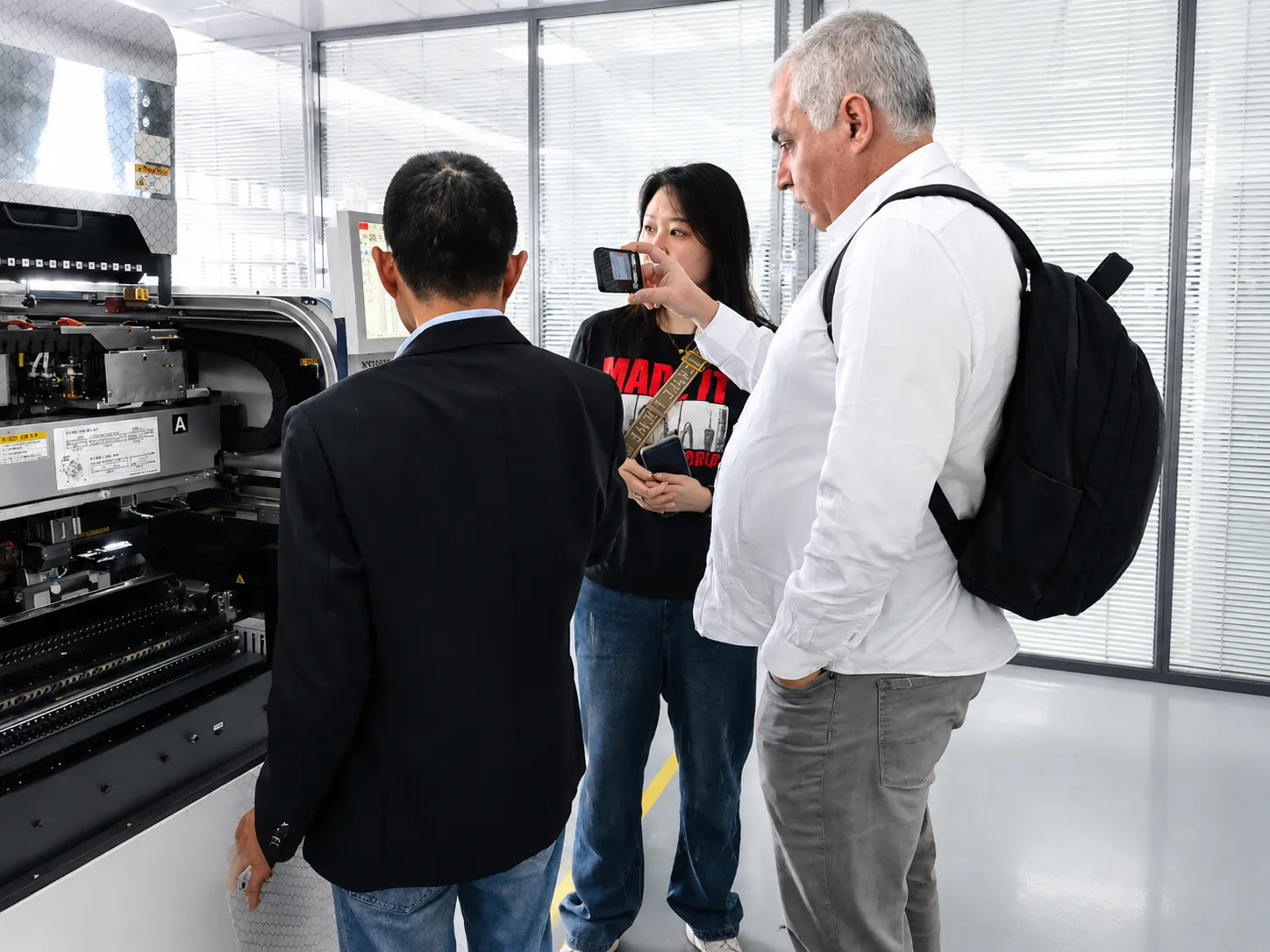

Visitors in a workshop standing beside production equipment while an operator explains the machine
Reference visits and training sessions are what a scorecard cannot show: how a supplier behaves after the invoice is paid.

Payment Protection Strategies

Never pay 100% upfront — payment is your strongest lever. JHIMS terms: 70% T/T deposit + 30% before shipment, L/C at sight for established customers.

Method Protection Level How It Works Best For
L/C at Sight Strongest Bank pays only against compliant shipping documents Large orders, new suppliers, first-time buyers
70% T/T deposit + 30% before shipment Strong (recommended) Balance paid against the pre-shipment inspection report, photos and video Most SMT equipment purchases
Platform guarantee / escrow Strong Payment held until you confirm delivery Platform-mediated first orders
100% T/T upfront ❌ Avoid Full payment before any evidence of production Never for a new supplier
Personal bank account ❌ Avoid Payment to an individual, not a company Never — a fraud red flag

Contract Protection: What Every SMT Equipment Contract Should Include

A handshake and a proforma invoice are not a contract. Before any deposit, cover six items in writing — resistance to any is a warning sign.

  • Performance guarantees — Binding, measurable specifications in the contract: rejection rate, UPH, changeover time. Example: “rejection rate below 0.5% on the agreed lens set”.
  • 30-day acceptance period — After installation, you can request remedies — or return the equipment — if it fails the performance guarantees.
  • Warranty terms — 1-year parts + labor minimum; confirm remote diagnostics response time and spare-parts dispatch commitment in writing.
  • Bilingual contract — English + Chinese versions with a clause stating both are equally authoritative — this prevents translation disputes.
  • Neutral arbitration venue — For example, Hong Kong International Arbitration center (HKIAC) or Singapore International Arbitration center (SIAC), rather than mainland-only courts.
  • Documentation deliverables — Machine birth certificate (QC checklist), burn-in test report, CE declaration, ISO certificate copy and full export documentation.

Logistics, Customs & Duties: What Changes the Final Price

Freight, duties and clearance add 10–25% to the quoted price — or cut 5–15% with the right preference certificate. Plan these four first:

  • HS code: SMT vibratory feeders, for example, classify under 8479.89 (machines having individual functions). Confirm the correct classification before quoting to avoid customs delays.
  • Duty preference certificates: Form E (ASEAN–China FTA) and Form F (China–Chile FTA, etc.) can reduce import duties by 5–15%. Confirm eligibility with your customs broker.
  • Incoterms decision: DDP (Delivered Duty Paid) gives first-time buyers the safest experience — the seller handles shipping, insurance, export and import clearance and duties. CIF (Cost, Insurance, Freight) is the next safest. Avoid EXW for first orders.
  • Packaging compliance: Verify ISPM-15 fumigated wooden crates with shock and tilt indicators — required for international shipment and protects the equipment in transit.
Field rule: if a supplier ships internationally every week, they can quote DDP without hesitation. Hesitation here is a verification signal.

Procurement Pitfalls and How to Avoid Them

Most sourcing failures are bought, not born — the damage is done before the PO is signed. Avoid these eight:

  • Comparing purchase price only — freight, duties, spares and downtime usually exceed the price gap between suppliers
  • Skipping the 5-step verification because the website looks professional
  • Paying 100% upfront — the single most common cause of failed imports
  • Accepting a PDF certificate without verifying it on the certifying body’s registry
  • Signing without performance guarantees or a 30-day acceptance period
  • Choosing EXW for a first order and ending up managing freight, insurance and customs alone
  • Ignoring duty preference certificates and paying 5–15% more import duty than necessary
  • Having no acceptance plan — no documented specification to test against on arrival

The pitfalls fall into two families. First, verification debt: checks skipped, certificates accepted as PDFs, references never called.

The fix is procedural: put the five checks in the purchase calendar with dates; an unanswered check is a failed check.

Second, commercial optimism: paying 100% upfront for a discount, choosing EXW on a first order, or having no acceptance plan.

The fix is the same document: performance guarantees, an acceptance period, the Incoterm decision and landed-cost calculation must all land before the deposit.

Why JHIMS: A Supplier That Survives Its Own Scorecard

JHIMS (Shenzhen Jinghe Technology Co., Ltd.) has manufactured industrial automation equipment in Shenzhen since 2012 and is ISO 9001:2015 certified. Test us the same way:

  • Registration and factory: a manufacturing-scope company registry entry, a factory floor you can tour live on a video call, and an engineering team on site.
  • Certification and patents: ISO 9001:2015, plus patented technology such as the dual-frequency vibration drive on the DPS-2 lens feeder.
  • References: real customers across industries and regions — see the documented KPI transition in our SMT lens feeder ROI case study.
  • After-sales: under 4-hour response time and under 48-hour spare-parts dispatch commitment, a 30-day acceptance period and a 48-hour aging test before every unit ships.
  • Payment and contract: 70% T/T deposit + 30% before shipment (L/C at sight for established customers), bilingual English/Chinese contracts and neutral arbitration.
SMT equipment factory floor under assembly and testing in China
Inside the JHIMS manufacturing operation: assembly, testing and aging areas are open to verification

Method applied: the automatic SMT lens feeder guide for an 8–10 year decision, the turnkey factory case study, and the L12 printer for panels up to 1,200 × 350 mm.

Watch our factory and machine videos on YouTube before you call us.

The most powerful verification step: for lens feeder projects, send your lens samples for a free 48-hour feeding test and measure the rejection rate on your own product.

Running Supplier Verification on a Live RFQ

Verification pays off only if it runs before negotiation closes. Calendar: certificate checks in week one, tours and references in week two.

Same RFQ package to every candidate:

  • Your specification and product data
  • Acceptance criteria you intend to write
  • Your payment structure and Incoterm
  • Documentation expected at handover

A price alone means the engineering conversation was skipped; a configuration, lead time in working days and exclusions in writing mean it was read.

Align every quotation on the same Incoterm, commissioning and spare-parts list. A 40–60% saving counts only against comparable equipment.

Second question: what if the machine does not meet the agreed spec after installation? A supplier citing a contract clause, measurable values, an acceptance period and a remedy is held to the numbers.

Best efforts is a supplier to drop, however competitive the price — an unenforceable promise is paid for later, in full.

The RFQ package below makes answers comparable. Send the same items to every candidate and score the replies.

RFQ item What to send or ask What a serious answer looks like
Specification The machine or feeder you need, with product and lens data A configuration with model, channel count and options, not a generic price list
Verification Request for registry scope, live tour, certificate number, references, patents Answers to all five, with a tour date offered inside the same week
Acceptance criteria The measurable output you will accept the machine against A contract clause with defined values and a stated acceptance period
Payment structure Your proposed deposit and balance terms Agreement to 70% deposit and 30% before shipment, or L/C at sight
Incoterm The term you want quoted, DDP preferred for a first order A DDP or CIF quotation with freight and clearance identified separately
Documentation Test records, machine documentation, warranty statement, spare-parts list A list of what is delivered, with timing, not a promise to provide it later
Lead time Build time and shipping method to your site Working days for build plus air or sea transit, with the customs step named
Exclusions What is not covered by the quotation A written list: on-site labor, duty, air supply preparation, extra tooling

Risk After Delivery: Spares, Training and Warranty Enforcement

The most underestimated risk starts when the machine runs: parts were built elsewhere, so the question is not whether a part fails but how many days the line waits.

Ask for a spare-parts list with prices and dispatch times first:

  • Consumables and wear items: stock locally.
  • Electronics and modules: from the supplier.
  • Dispatch time in the contract: hours or days.

Where the control platform uses open industrial components, the same part can often be bought locally, shortening the wait without the supplier.

Warranty enforcement needs a definition, a measurement and a remedy route:

  • Coverage and duration
  • Who pays parts, labor and freight
  • How a claim is raised: contact, response time, diagnostics

A machine only the supplier can set up is a permanent dependency. Budget one to three days of operator training and a maintenance session at commissioning.

Collect what future claims need: acceptance and test records, machine documentation set, warranty statement, spare-parts list with part numbers.

The table lists the post-delivery exposures that decide the real cost of an imported machine, and the clause that answers each.

Post-delivery risk The exposure What to agree before the order
Wear parts Line stops waiting for a low-value item Local stock list agreed at order and shipped with the machine
Electronics and modules Days of downtime per failure Spare-parts price list with a stated dispatch time in the contract
Process knowledge Only the supplier can set up or re-tune the machine Operator and maintenance training during commissioning
Warranty scope Dispute about what is covered, and who pays freight and labor Written warranty statement naming parts, labor, freight and duration
Diagnosis time Slow fault isolation across time zones Named contact with a response-time commitment and remote diagnostic process
Documentation Acceptance evidence missing when a claim is raised Handover file: test records, machine documentation, certificates
Tooling for new products Later tooling becomes single-source and priced accordingly Tooling price list and lead time agreed at the original order
Software and recipes Parameters lost after a fault or a replacement part Backup of machine parameters and recipes, with restore procedure
Repeat orders Second machine arrives to a different specification Configuration record kept against the serial number
Yamaha YSM40R pick-and-place machines standing in a warehouse hall with flooring markings
Machines staged before shipment: the same handover discipline that produces the documentation set a future warranty claim depends on.

Frequently Asked Questions

How much can I really save by sourcing SMT equipment from China?▼
40–60% compared with Japanese or European equivalents for comparable equipment. The savings are real — but they only materialize when the supplier passes verification. The cheapest quote from an unverified trading company is usually the most expensive machine you will ever buy.
How do I know if a Chinese supplier is a real manufacturer or a trading company?▼
Run the 5-step verification: check the business registration scope on gsxt.gov.cn (it must include “manufacturing”), demand a live video factory tour, verify the ISO certificate on the certifying body’s registry, call 2–3 reference customers, and search claimed patents. Around 60–70% of “factory” claims are trading companies, so assume nothing.
What is the safest payment method when buying from a new Chinese supplier?▼
L/C at sight is the strongest. For most SMT equipment purchases, 70% T/T deposit + 30% before shipment — with the balance paid against a pre-shipment inspection report — keeps the buyer in control. Platform escrow works for first orders. Never pay 100% upfront, and never pay a personal bank account.
How do I verify a supplier’s ISO 9001 certificate?▼
Do not accept a PDF. Look up the certificate number on the certifying body’s public registry (e.g. SGS, TÜV, BSI) and confirm the certificate scope covers design and manufacturing — not just sales.
What must be in my SMT equipment purchase contract?▼
Performance guarantees with measurable specs (rejection rate, UPH, changeover time), a 30-day acceptance period with remedies, warranty terms (1-year parts + labor minimum), a bilingual English/Chinese version with equal authority, neutral arbitration (e.g. HKIAC or SIAC) and documentation deliverables such as the burn-in test report and CE declaration.
What Incoterm should a first-time buyer choose?▼
DDP (Delivered Duty Paid) — the seller handles shipping, insurance, export and import clearance and duties, which removes the most common failure points for first-time importers. CIF is the next safest. Avoid EXW for first orders.
Which HS code applies to SMT equipment imports?▼
It depends on the machine. SMT vibratory feeders, for example, classify under 8479.89 (machines having individual functions). Confirm the correct classification with your customs broker before quoting to avoid delays and penalties.
Can Form E or Form F reduce my import duties?▼
Yes. Form E (ASEAN–China FTA) and Form F (China–Chile FTA, etc.) can reduce import duties by 5–15%. Eligibility depends on your country and the equipment — confirm with your customs broker.
Should I visit the factory before buying?▼
Yes — an on-site visit is the strongest verification step. If that is not possible, a live video tour is a solid minimum. A genuine manufacturer can show its floor on a video call within minutes.
What warranty and after-sales support should I expect?▼
A 1-year parts + labor warranty as a minimum, a documented response-time commitment, and a spare-parts dispatch commitment. JHIMS, for example, commits to under 4-hour response and under 48-hour spare-parts dispatch, plus a 30-day acceptance period.
How do I protect against a supplier disappearing after payment?▼
Structure payment so the supplier never holds 100% of your money before delivery (70/30 T/T or L/C at sight), tie the balance to a pre-shipment inspection, sign a contract with neutral arbitration, and verify the supplier’s manufacturing substance before the first dollar moves.
Can I test the equipment before paying?▼
Yes — and you should. Ask for a machine demo, run sample products, and link acceptance to the payment milestones. For lens feeders, JHIMS offers a free 48-hour feeding test: send your lenses and we report the measured rejection rate.
What total cost should I model beyond the purchase price?▼
Freight and insurance, import duties (minus Form E/F savings), installation and commissioning, spare parts, preventive maintenance and downtime. For long-life equipment, purchase price is typically only 30–40% of 8-year total cost of ownership.
What documents should I receive with the machine?▼
A machine birth certificate (QC checklist), burn-in test report, CE declaration, ISO certificate copy and full export documentation. If any of these is missing, treat it as a verification failure.
How long does shipping and customs clearance take?▼
It varies by route, Incoterm and equipment size. Confirm the lead time and shipping schedule in the contract, and choose DDP so the seller owns the clearance process — this removes the most common source of delay for first-time buyers.
Why should I buy from JHIMS?▼
JHIMS is a factory-direct manufacturer founded in 2012 and ISO 9001:2015 certified, with patented technology, under 4-hour response and under 48-hour spare-parts dispatch, 70/30 payment terms, bilingual contracts, a 30-day acceptance period and a 48-hour aging test before shipping. We publish the verification framework in this guide because we are happy to be verified against it.
How many suppliers should I put on a shortlist?▼
Three to five candidates is the working range: enough to keep commercial leverage and to compare answers against each other, few enough that the verification checks can still be run properly on every one of them in a single week.
What should be in the first RFQ package?▼
Your specification with product data, the acceptance criteria you intend to write, your proposed payment structure, the Incoterm you want quoted, the documentation you expect at handover, and a request for the five verification items. Send the same package to every candidate.
How do I compare quotations that use different Incoterms?▼
Convert all of them to the same delivered basis before comparing, adding freight, insurance, duty and clearance where they are excluded. First-time buyers are usually safest with DDP, because the seller carries shipping, export and import clearance and duties.
What should I look for in a live factory tour?▼
Machining, assembly, testing and aging areas, and the people working in them, in real time rather than in photographs. Ask for the burn-in area specifically: a factory that runs its own machines before dispatch has somewhere for that to happen.
How should I plan spare parts for imported equipment?▼
Split the list into wear items you hold locally and modules that come from the supplier, then attach a dispatch time to the second class in the contract. Where the control platform uses open industrial components, the same part can often be sourced in your own country as a backstop.
What documentation should I collect at handover?▼
The acceptance and test records with measured values, the machine documentation set, the warranty statement, the spare-parts list with part numbers, and a backup of machine parameters and recipes with a restore procedure. Collect it while the supplier still has every reason to be helpful.

Ready to Source SMT Equipment with Confidence?

Contact our engineers for a free evaluation, first reply within 12 working hours (Mon–Sat, 09:00–23:00 China Standard Time, UTC+8) — and for lens feeder projects, send your lens samples for a free 48-hour feeding test.

Before you commit to a supplier, look at machines actually running: Yamaha YSM40R in production, factory and equipment videos on the JHIMS channel, or ask a specific sourcing question on WhatsApp.

📞 (86-755) 86700443✉ [email protected]

More procurement and process guides are in our technical blog.
